Building your own home is one of the biggest financial decisions you will ever make, and the first question everyone asks is simple. How much will it actually cost? This guide breaks down the 1 kanal house construction cost in Pakistan for 2026 in plain language, so you can plan a realistic budget before you lay the first brick.

One note before we start. Nobody can give you an exact figure, because cement, steel and labour rates change through the year and every design is different. What follows are working ranges you can plan around, then confirm with two or three local quotations.

First, Understand the Covered Area

A 1 kanal plot measures 20 marla, or about 4,500 square feet of land. But you never build on all of it. Setbacks, a lawn, a car porch and open space take up a share. A well-planned 1 kanal house plan helps you make the most of the available space while keeping these requirements in mind.

For a standard double storey house, the covered area usually lands somewhere between 5,000 and 7,000 square feet once you count the ground floor, the first floor and the rooftop portion such as the stairwell and servant quarter. If you add a full basement, that adds roughly another 2,500 to 2,700 square feet.

This number matters more than anything else in your budget. Almost every rate you will be quoted is a per square foot rate. So a house with 5,000 square feet of covered area and one with 7,500 will differ hugely in price, even on the same size plot.

1 Kanal House Construction Cost in 2026: The Overall Range

Here is the realistic picture for 2026, assuming a standard double storey house with no basement.

Standard of construction Approximate total range
Economy PKR 3.5 to 4.0 crore
Standard or mid range PKR 4.0 to 4.5 crore
Premium PKR 5.0 crore and above
Full basement Add roughly PKR 2.0 crore and above

Expressed per square foot, the all inclusive rate for 2026 generally falls between PKR 5,000 and PKR 8,500, depending on the quality you choose and where you build. These figures sit a little above 2025 levels, which is normal given how steel, cement and labour rates have moved.

Construction is almost always split into two stages, and it helps to think about them separately.

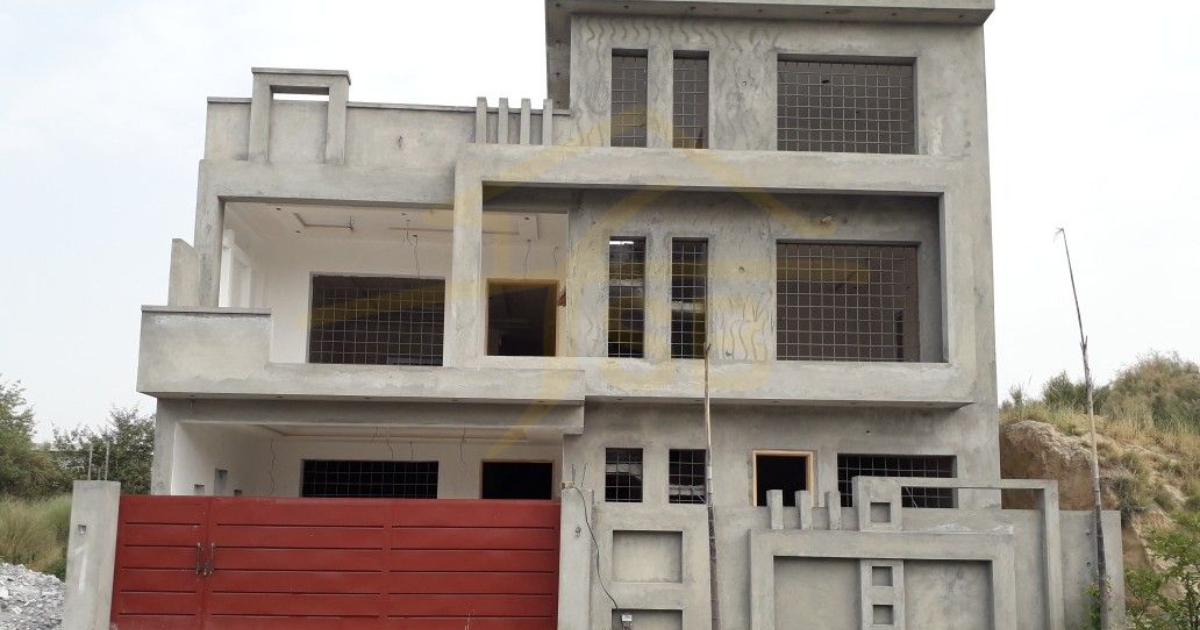

Grey Structure Cost

Grey Structure Cost

The grey structure is the skeleton of your house. It covers excavation, the foundation, columns and beams, roof slabs, brickwork, plaster, and the pipes and wiring conduits that get buried inside the walls. When the grey structure is finished, the house is standing and weatherproof, but there are no tiles, no paint, no doors and no fittings.

For 2026, grey structure rates generally run between PKR 3,000 and PKR 4,000 per square foot. On a 5,000 square foot covered area, that works out to roughly PKR 1.5 to 2.0 crore. In DHA and similar high specification societies, the same work commonly costs more because of stricter byelaws, better material specifications and higher labour rates.

The grey structure usually takes a little more than half of your total budget. It is also the stage where cutting corners is most dangerous. When planning grey structure services, steel quantity, concrete quality, and foundation depth are not places to save money. You cannot fix these things later without breaking the house.

Finishing Cost

Grey Structure Cost

Finishing is everything that makes the house liveable and good looking. Flooring, tiles, paint, false ceilings, doors and windows, kitchen cabinets, wardrobes, bathroom fittings, light fixtures, external elevation work and the boundary wall all sit here.

As a rule of thumb used across the industry, finishing costs roughly the same as the grey structure. For 2026, finishing rates range from about PKR 3,500 per square foot at an economy level to PKR 6,000 or more per square foot for premium work with imported tiles, solid wood joinery and designer fittings.

Finishing is where your budget has the most to give. The gap between a simple, clean finish and a luxury one can easily be a crore on the same structure. It is also the stage most likely to go over budget. Small upgrades feel cheap one at a time, but they add up fast.

Where the Money Actually Goes

Breaking the total into work categories makes the budget easier to control.

Work category Rough share of total
Foundation and structure 55 to 60 percent
Wood, metal and tile work 22 to 27 percent
Electrical work 6 to 8 percent
Plumbing 5 to 6 percent
Fittings and fixtures 3 to 4 percent

Labour alone typically accounts for around 30 to 35 percent of the total, with materials making up the rest. When material prices rise sharply, that balance shifts.

Why Location Changes the Price

Two identical houses can cost very differently depending on where they stand.

DHA and other premium societies sit at the top of the range. Building byelaws are stricter, inspections are tighter, the expected finish level is higher, and contractors charge more to work there. Construction in DHA commonly runs twenty to thirty percent above a comparable house in an ordinary private society.

City matters too. Lahore, Karachi and Islamabad usually sit at the higher end, because labour and transport cost more and standards are higher. Faisalabad, Multan, Gujranwala and smaller cities often come in ten to twenty percent lower for the same specification.

Site conditions are the quiet factor. Soft soil, a high water table, a big level difference or poor access all mean deeper foundations and more earthwork. That bill arrives before the house even appears above ground.

Choosing How You Build

How you contract the work changes both your cost and your stress level. Choosing a reliable construction company can also make a major difference, especially when you are managing a project as large as a 1 kanal house.

With a labour rate contract, you buy all materials yourself and pay the contractor only for labour. This is the cheapest option on paper and gives you full control over quality. But it needs your time almost daily, and real knowledge of materials.

With a grey structure contract, the contractor supplies both materials and labour for the structure at a fixed per square foot rate, and you handle finishing separately. This is the most popular middle path.

With a turnkey contract, the contractor delivers a complete, ready to move in house at an agreed rate. It costs more, but the price is predictable and the responsibility is theirs. Whichever you pick, get the specification written down in detail, because most disputes come from vague wording rather than dishonesty.

Costs People Forget to Budget

Several real expenses sit outside the per square foot rate, and they surprise first time builders.

You will need an architect and structural design fee, map approval and society charges, and utility connection charges for electricity, gas and water. Then come the boundary wall and main gate, the driveway and landscaping, a water tank and pump, and a generator or solar setup if you want one.

Many people also forget site security, a temporary water and electricity connection during construction, and the cost of a supervisor if you are not on site yourself.

Set aside a contingency of around ten percent of your total budget. On a project this size, something always comes up.

Practical Ways to Control the Cost

Finalise the design fully before work starts. Design changes during construction are the single most expensive mistake in home building. Buy major materials such as steel and cement in planned lots rather than in a rush, because panic buying always costs more. Keep the shape of the house simple, since complicated shapes, many corners and long spans all add steel and labour. Spend well on the things you cannot change later, meaning the structure, waterproofing and plumbing. Save on the things you can upgrade in five years, such as tiles, paint and light fittings.

Frequently Asked Questions

What is the total 1 kanal house construction cost in Pakistan in 2026?

For a standard double storey house without a basement, expect roughly PKR 3.1 to 3.8 crore. Economy builds start lower and premium builds in DHA go well above this.

What is the covered area of a 1 kanal house?

Usually about 5,000 to 6,300 square feet for a double storey house, plus roughly 2,500 to 2,700 square feet if you add a full basement.

How is the cost split between grey structure and finishing?

Roughly half and half. Finishing is generally close to the grey structure in cost, though it varies far more with your choices.

Is building in DHA more expensive?

Yes. Stricter byelaws, higher material standards and higher labour rates typically push DHA construction twenty to thirty percent above an ordinary society.

How long does a 1 kanal house take to build?

Usually twelve to eighteen months. The grey structure takes about six to eight months and finishing takes the rest, depending on weather, funding flow and how quickly you make decisions.

Should I build or buy a ready made house?

Building usually costs less per square foot and gives you exactly the layout you want, but it takes time and attention. Buying is faster and more certain. The right answer depends on how much of your own time you can give the project.

Final Word

The 1 kanal house construction cost in Pakistan for 2026 sits broadly between PKR 4 crore and PKR 5 crore for a good quality standard home. The final number comes down to three things: your covered area, your finishing choices and your location. Treat these ranges as a planning tool. Get written quotes from two or three contractors on the same written specification, and keep a contingency aside. A clear budget before you start is worth more than any saving you will find later
